Overview

The Transforming Environment Data Solutions project revolutionized data management for Western Australia’s DWER by implementing an automated Power BI solution for the Pilbara Environmental Offsets Fund. By converting manual processes to streamlined workflows, this award-winning initiative enabled conservation staff to focus on environmental outcomes rather than spreadsheets, while dramatically improving efficiency and decision-making capabilities.
1. Business Challenge
Problem Statement
The Pilbara Environmental Offsets Fund (PEOF) manages critical conservation projects across Western Australia but faced significant operational challenges:
- Manual Process Inefficiency: Staff spent 48+ hours monthly on Excel data entry and processing, diverting resources from conservation work
- Data Quality Concerns: 28% of reports contained errors requiring correction, undermining confidence in financial decision-making
- Reporting Delays: Conservation decisions delayed by an average of 12 days due to fragmented systems and manual validation requirements
- Stakeholder Frustration: Program managers, field teams, and leadership all experienced distinct pain points throughout the reporting workflow

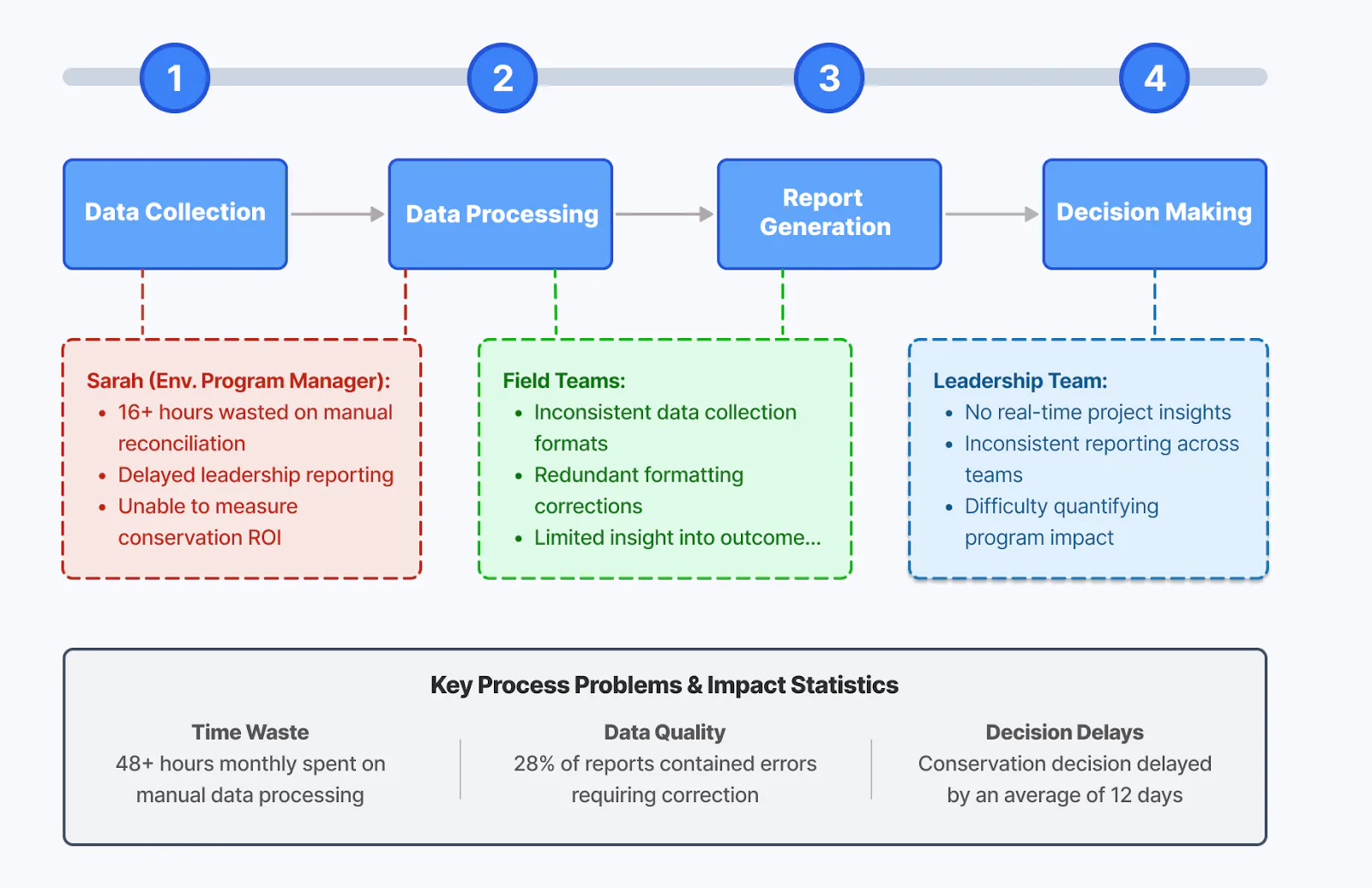

PEOF Data Workflow: Stakeholder Friction Points

2. Solution Overview

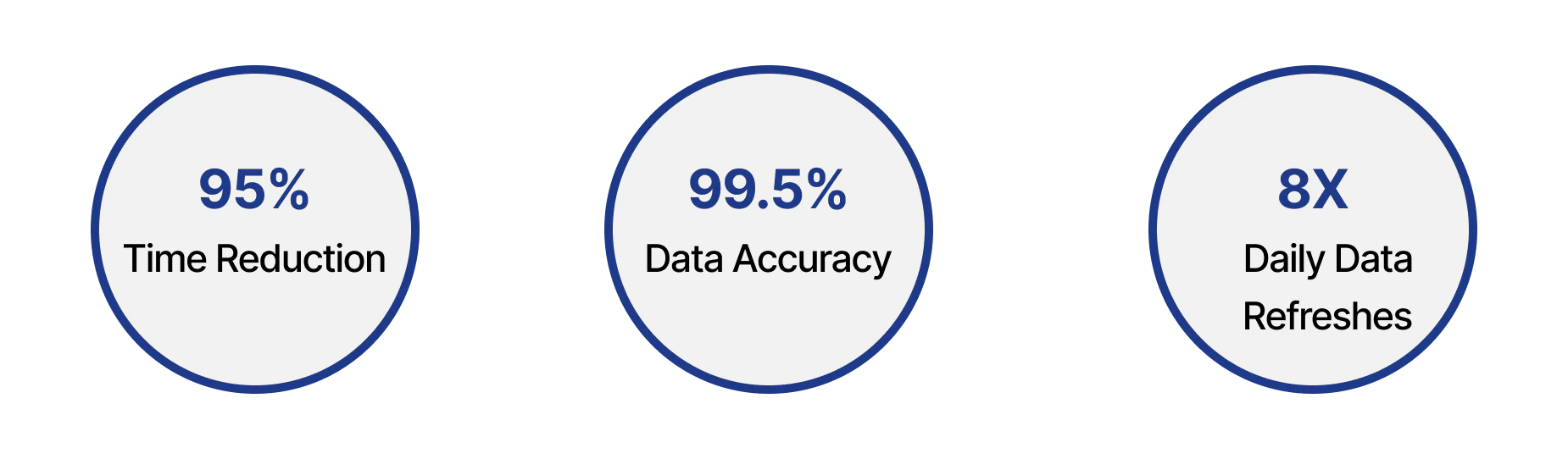

Transformed PEOF’s environmental data management by implementing an integrated Microsoft Power Platform solution that reduced reporting time by 95%, improved data accuracy to 99.5%, and enabled real-time decision-making through automated refreshes.

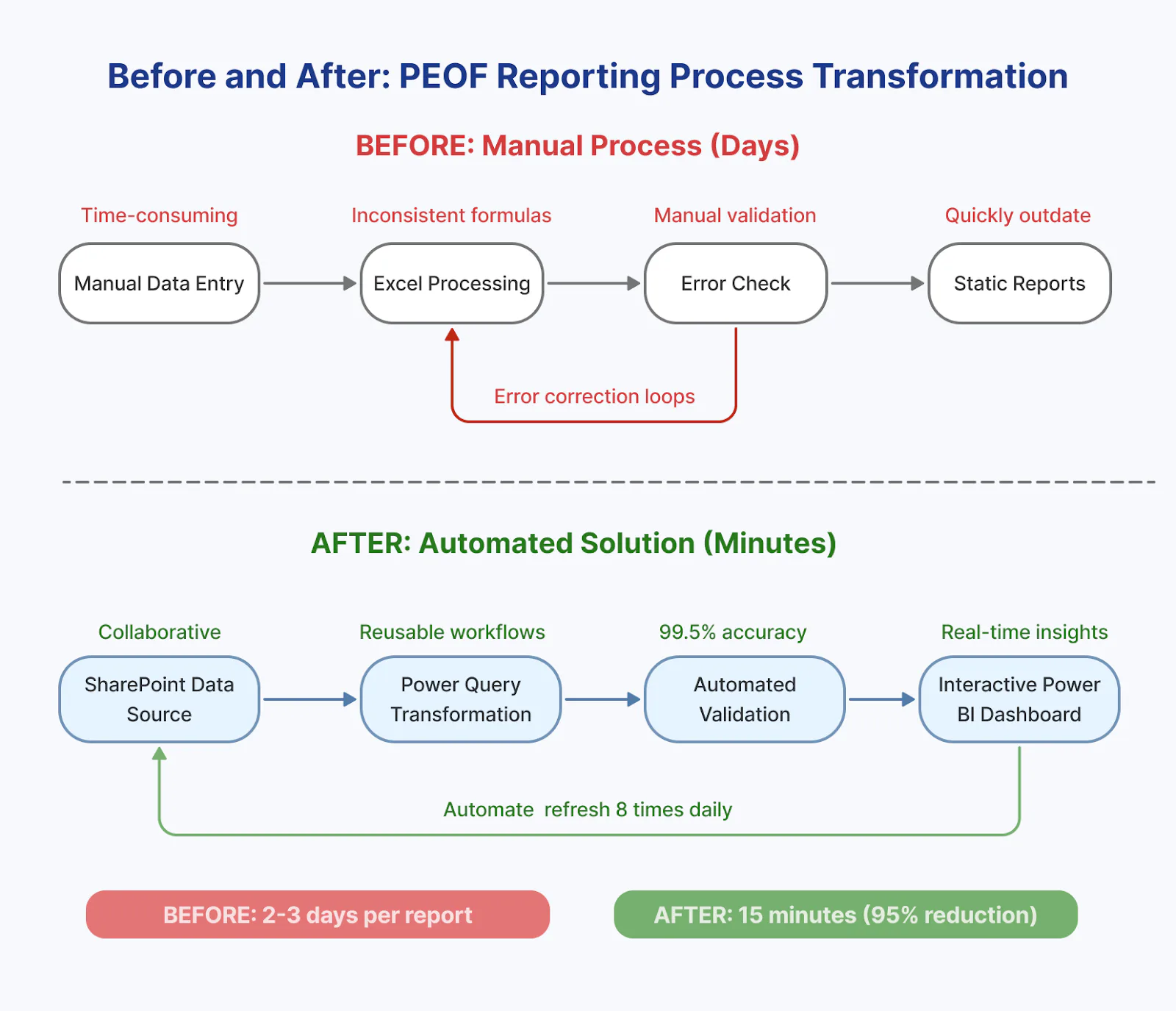

The diagram below illustrates the transformation from manual to automated workflow.

3. Project Management
We managed the project using a straightforward waterfall approach with five key phases, making it easy for everyone to understand where we were in the process:
- Requirements & Discovery: We sat down with stakeholders to really understand their pain points and what they needed from the solution.
- Design & Prototype: We sketched out the solution and created interactive mockups for the team to test and validate.
- Implementation: This is where we built the data pipelines, validation rules, and interactive dashboards.
- Testing & Validation: We thoroughly checked everything to make sure all reports were accurate across different scenarios.
- Training & Handover: We created user-friendly documentation and ran hands-on sessions so the team could maintain the system themselves.

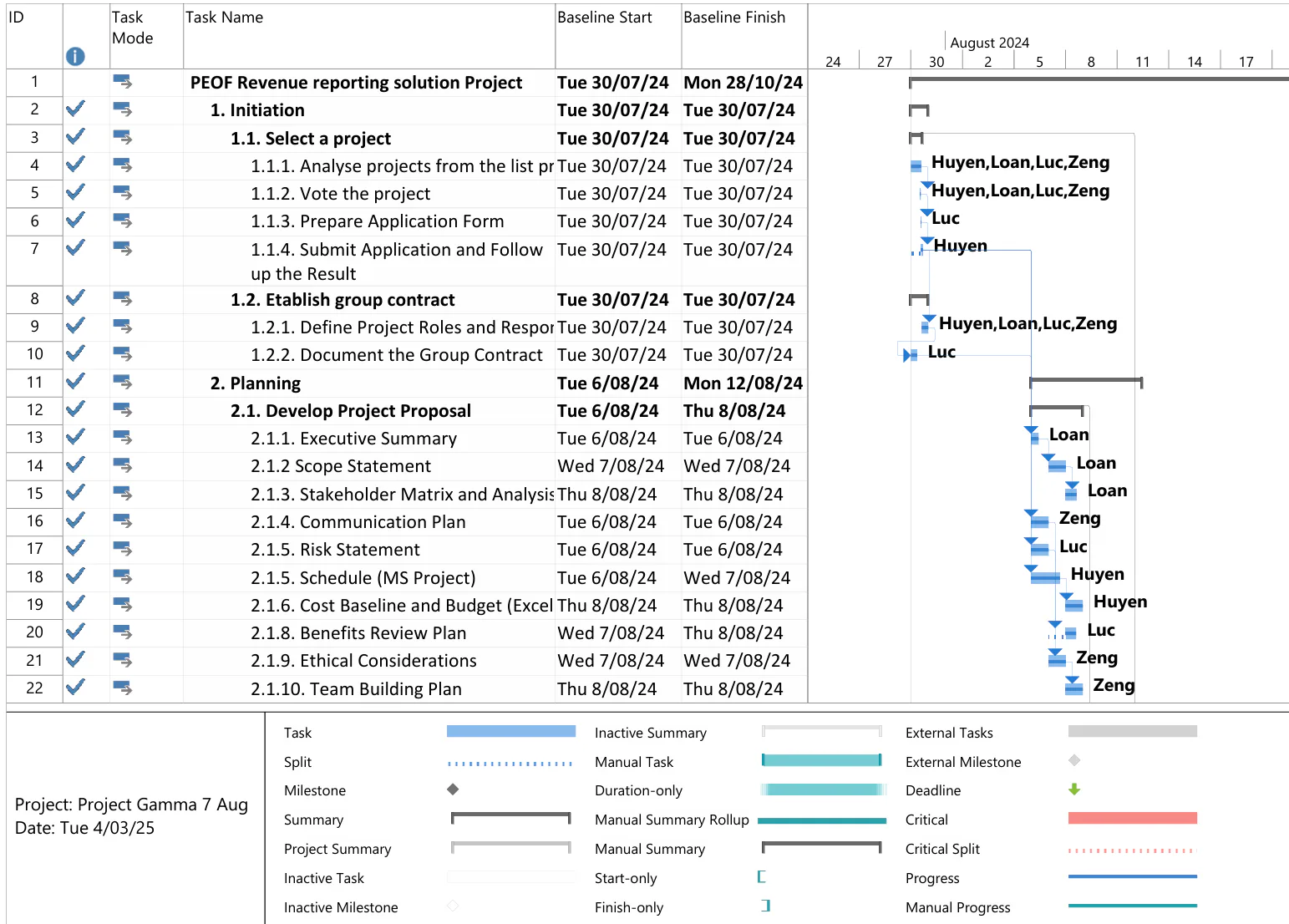

We tracked timeline and team responsibilities with Microsoft Project, hitting all our milestones on time while keeping everything within budget.

4. Project Stages

4.1. Requirements Analysis
Challenge: Complex environmental data workflows with high error rates causing delayed conservation decisions.
Solution:
- Interviewed stakeholders to identify specific pain points
- Analyzed 18 months of historical data revealing 28% error rate
- Documented 48+ hours of monthly manual processing
- Created measurable success criteria for the solution
4.2. Data Transformation
Challenge: Transform inconsistent financial data from multiple Excel files with duplicates and formatting issues into reliable, structured information while enabling non-technical staff to maintain the system.
Raw Data Issues:

- Multiple Excel files with inconsistent formats
- Duplicate entries across files
- Negative values shown in red without proper formatting for calculations
- Inconsistent company and project codes
- Manual validation required for each entry
Solution:
- Implemented Power Query transformation pipeline with 15+ steps
- Created standardized templates for consistent data entry
- Built automated validation with visual indicators for data quality
- Developed reusable transformation logic for future files

4.3. Visualization
Challenge: Translate complex environmental and financial data into actionable insights for diverse users.
Solution:
- Designed hierarchical data models supporting multi-level analysis
- Created role-specific dashboard views for different stakeholder needs
- Implemented DAX measures for environmental impact metrics
- Developed mobile-optimized views for field staff
Key Visualizations:

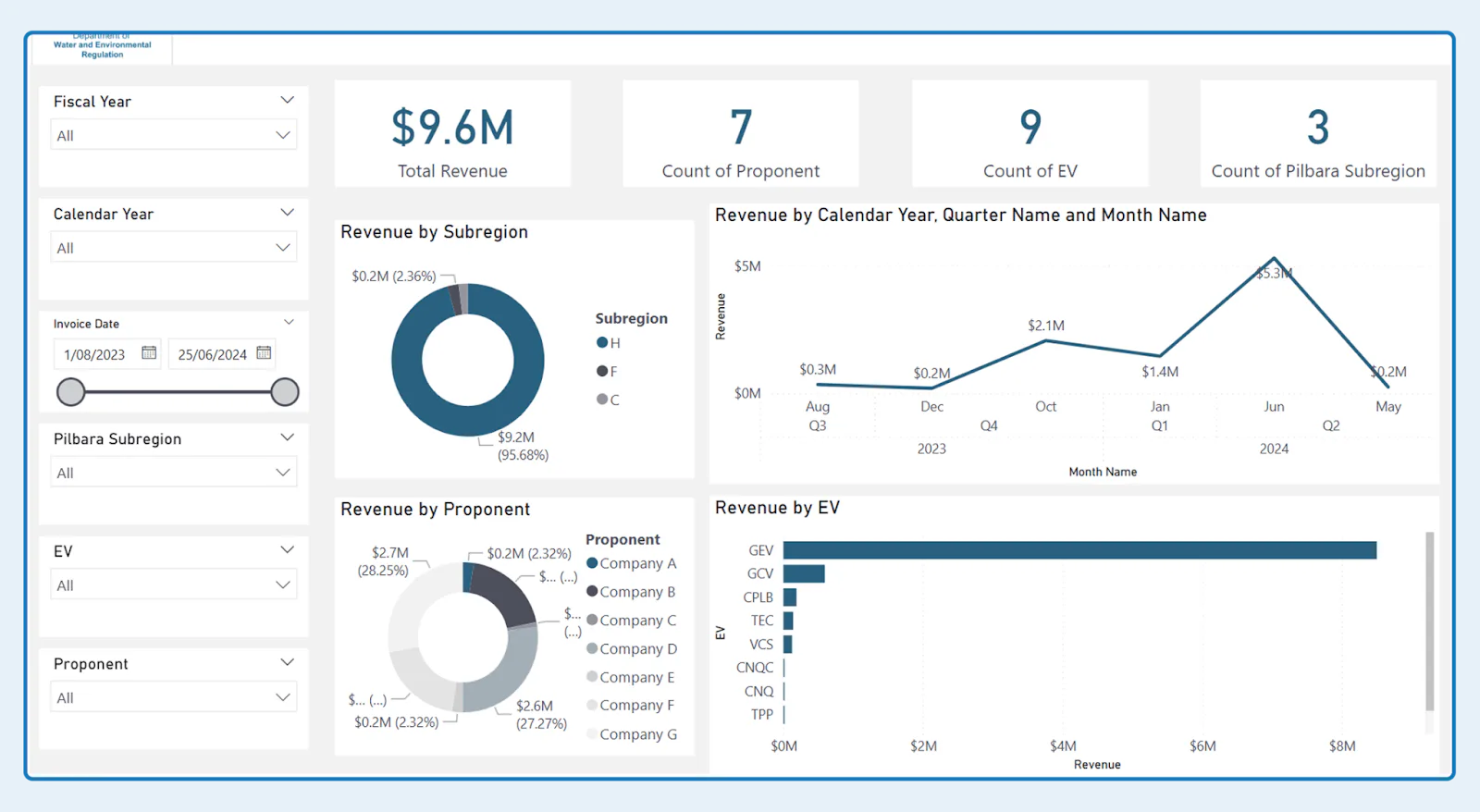

- Financial tracking with waterfall charts and conditional formatting
- Geospatial maps showing project distribution and impact
- Executive KPI dashboard for at-a-glance decision support
- Operational tables with status indicators

4.4. Integration & Knowledge Transfer
Challenge: Creating a sustainable solution requiring minimal IT support.
Solution:

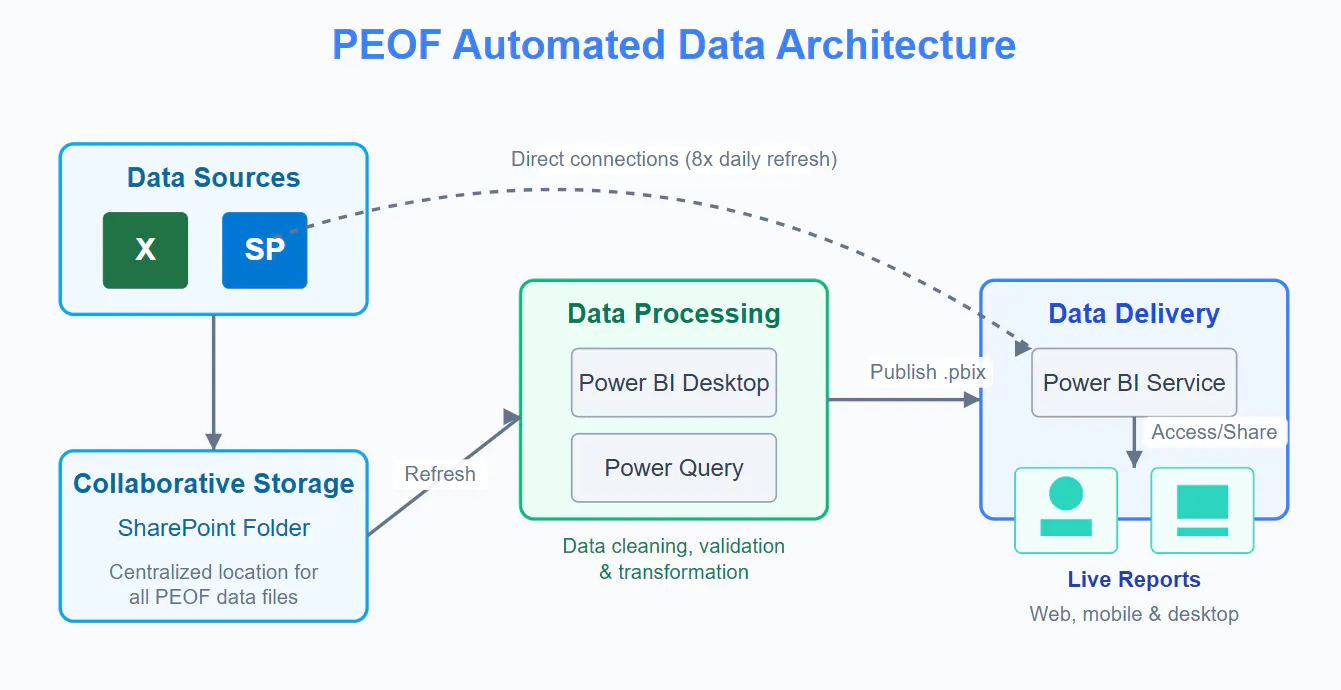

- Connected Power BI to SharePoint for live data updates
- Configured 8x daily scheduled refresh for near real-time monitoring
- Implemented secure data gateway connections
- Created notification system for validation issues
- Developed user documentation and conducted hands-on training
Results:
- Reduced reporting time from 3 days to 15 minutes, a 95% reduction
- Enabled real-time monitoring of conservation projects
- Established self-service reporting capabilities
- Solution adopted as template for future environmental projects

5. Impact & Recognition

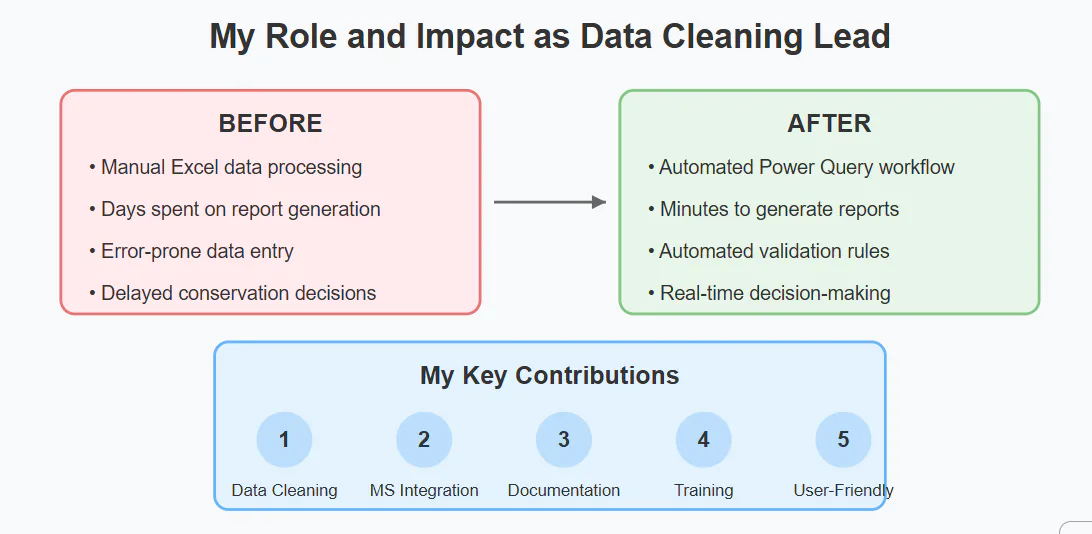

Key Results:
- Reduced processing time by 95%, from 48+ hours to minutes
- Improved data accuracy to 99.5% through automated validation
- Enabled real-time environmental decision-making
- Recognized as departmental case study for digital transformation
- Solution adopted as template for future DWER environmental projects
Client Feedback:
“Solution transformed how we manage conservation data, allowing staff to focus on environmental outcomes rather than spreadsheets.”
— Micheal, Environmental Program Manager

Award-winning solution recognized with “Best Project” and “Raving Client” honors at the MIS Capstone Integration Project (2024). Our team was voted #1 by peers, ECU staff, and received the highest client satisfaction rating for our PEOF data transformation work.
